CONSOLIDATED TEAM ACCOMPLISHMENT BT9

Published: August 8, 2024

July 30 to August 3, 2024, Tuesday to Saturday

BT9 Team Members: H Delfin, RV Fadirugao, A Daliva, MA Bolinas and F Distura
Accomplished:
1. Hauling of pole to Dumalag Area Office
2. Clearing of lines at Barangay Bag-ong Barrio, Dumalag
3. Replacement of rotten pole and rehabilitation of metering at Barangay Ongol Ilawod, Dumarao

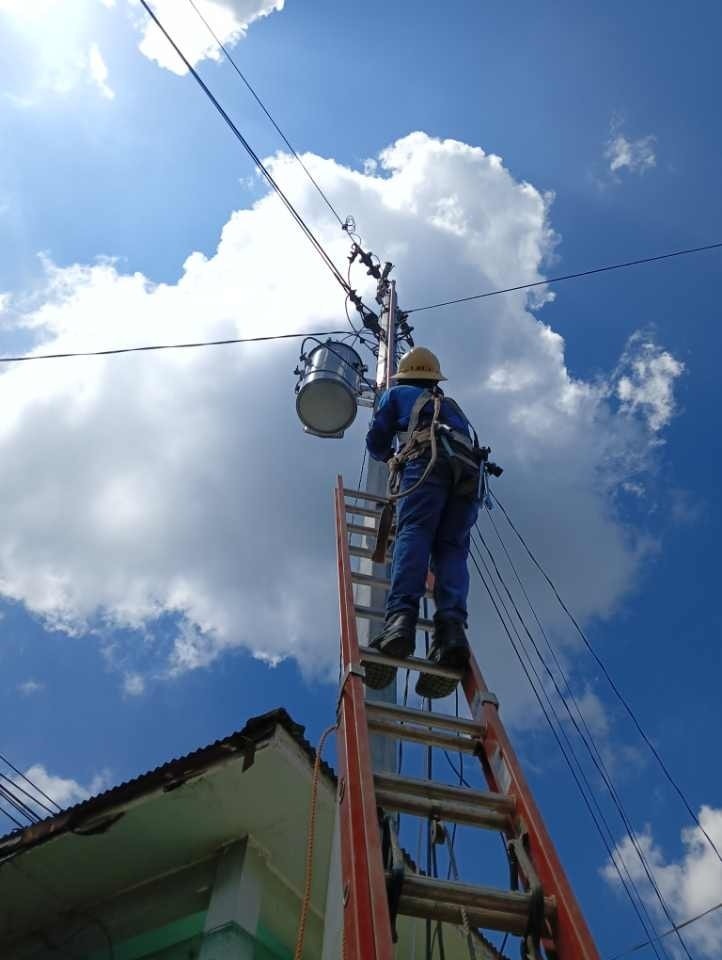

4. Installation of 50 KVA rental transformer at Barangay Aglalana, Dumarao
5. Replacement of defective insulator from Crossing Bailan, Pontevedra to Barangay Quinat-uyan. Maayon (done during the power interruption)
6. Replacement of rotten pole at Barangay Poblacion Tabuc, Maayon
7. Installation of 50 KVA rental transformer at Barangay Tinigban, Panitan
8. Insertion of intermediate pole and replacement of rotten pole at Barangay Pandan, President Roxas (mano-mano)
9. Replacement of rotten pole at Barangay Marita, President Roxas
10. Energization of new 3-phase line from Suhot blade at Barangay Dolores, Dumalag and line clearing operation (done during the scheduled power interruption)
